Who to Commission for a UK Cross-Dock Distribution Centre: Discipline and Firm Map
The procurement team behind a UK cross-dock distribution centre spans eleven disciplines, each with a distinct appointment sequence and typology-specific bench. This guide maps the verified UK firms by RIBA stage across cross-dock, fulfilment, hyperscale data centre, last-mile depot, and cold-store, identifying where the architect, MEP, and structural benches diverge by typology.
What Is a UK Cross-Dock Distribution Centre, and Why the Team Differs from a Standard Shed
A UK cross-dock distribution centre is a two-sided industrial building where goods arrive at one dock face, get sorted within the shell, and depart from a second dock face on the opposite elevation, and the team a developer commissions for it differs from the team for a high-bay storage shed because dock count, yard depth, sortation MEP, and slab specification are all driven by throughput, not storage. That throughput-first brief is why the same architect, MEP consultant, and planning team used on a high-bay warehouse cannot be lifted directly onto a cross-dock scheme.
The UK delivery context spans local-authority planning regimes that vary between unitary authorities (Slough, North East Lincolnshire) and two-tier districts inside county councils (Northamptonshire, Rutland), each with its own pre-application protocol and Section 106 negotiation pattern.
Throughput drives the cross-dock brief, not storage. Yard discipline and dock geometry come first, structure second, racking and automation last. The MEP consultant sizes dock-leveller power, yard lighting, and sprinkler density before the architect locks the floor plate. The structural engineer locks slab specification before the planning consultant files. Chetwoods' Altitude at Magna Park is the public 21 m exception, a 574,258 sq ft cross-dock for GLP; the typical UK cross-dock runs lower haunch and a clear-span flow corridor.
UK cross-dock specification, building and yard
Dock leveller height
1,200 mm to match a UK trailer bed.
Slab specification
FM1 across the cross-dock floor; FM2 only at any small rack island. A high-bay racking shed needs FM2 or FM3 across the whole floor to hold tolerance.
Haunch height
Lower than a 21 m racked unit because the floor plate is narrower and the building is doing flow, not vertical storage. Magna Park's 574,258 sq ft Chetwoods cross-dock for GLP is the public 21 m exception.
Yard depth
50 metres or deeper, sized for the 16.5 metre articulated HGV swing radius plus a marshalling lane. A standard storage shed accepts 35 to 40 metres because trailers spot for less time.
Column grid
12 metres or more between columns. A racked unit runs 8 to 10 metres because the rack drives the grid. The cross-dock has no rack to plan around.
Floor type
Rack-free or low-rack clear-span flow corridor between the two dock faces, not a forest of high-bay racking.
Marshalling area
Held along the dock face inside the building, not outside the dock door, with spotting positions pre-painted on the slab for repeatable trailer placement.
Engineering sequencing
Structural engineer locks slab specification before the planning submission, because the foundation strategy affects the basement plant footprint and the slab build-up affects floor level relative to surrounding ground. The visualisation partner needs the dock leveller height, the trailer pitch, and the yard swept-path study in the model before the first verified-view image goes to the planning officer.

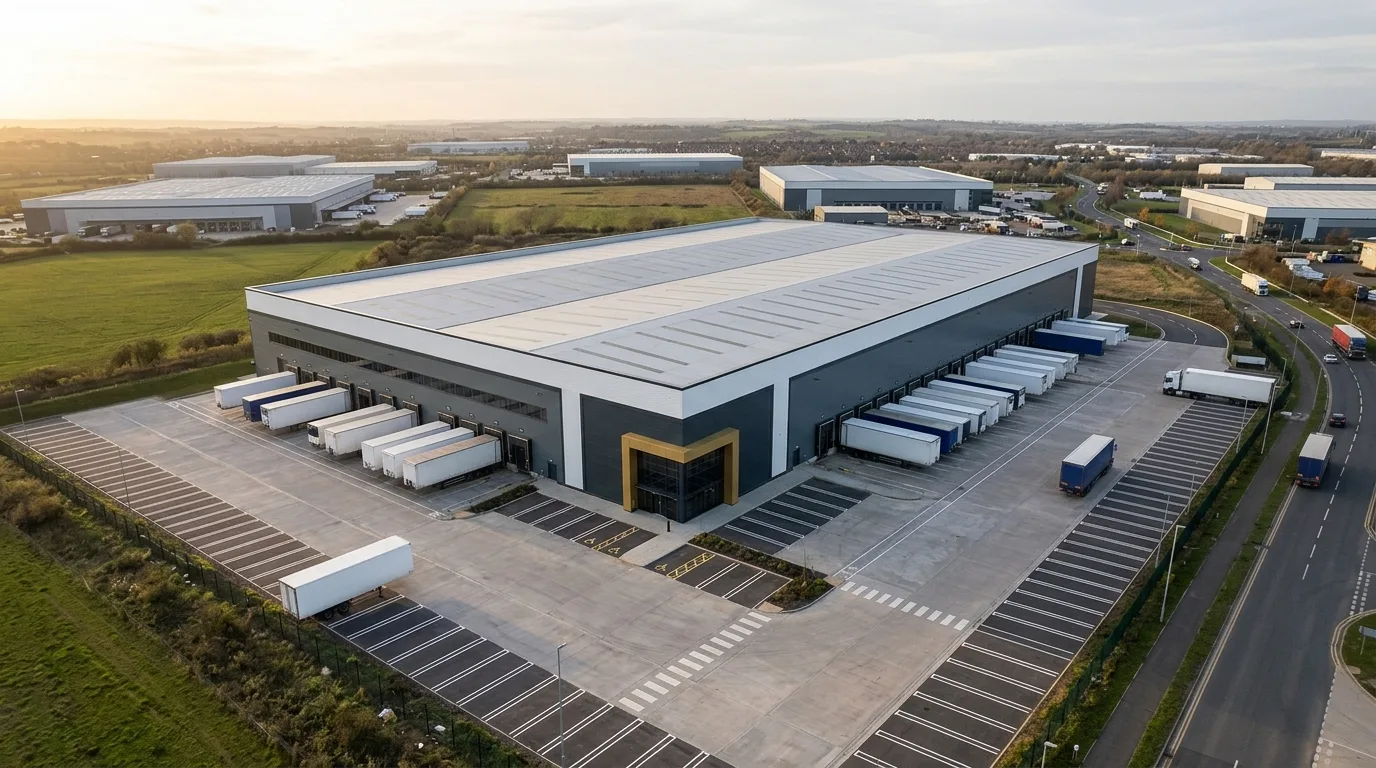

UK cross-dock distribution centre, two-sided dock arrangement with 50 metre yards, painted trailer spotting positions, and a clear-span flow corridor between the dock faces.
Headline picks for cross-dock
UK Cross-Dock Distribution Centre Design Team Headline Picks With Verified Project Credits
Eight disciplines, the firms most commonly on the shortlist, and one named UK project credit per row. Use it as a 30-second read of the bench. Use the discipline by typology matrix below for the full ranked picture across cross-dock, fulfilment, cold-store, hyperscale data centre, and last-mile depot.
Discipline
UK firms most commonly on the shortlist
Track record
Architect
UMC Architects, Chetwoods, Stephen George + Partners, Frank Shaw Associates, AEW Architects
UMC: DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent
Cross-dock, fulfilment, hyperscale data centre, last-mile depot, and cold-store each shift the bench in specific rows. The ranked matrix below groups the data by typology so a procurement brief can lift the columns directly.
UK design team shortlist, by industrial typology
Which UK Design Firms Shortlist For Cross-Dock, Fulfilment, Cold-Store, Hyperscale, And Last-Mile
Eleven UK design disciplines run down the rows; five UK industrial typologies run across the columns. Each cell labels the discipline's role on that build (Lead appointment, Core appointment, Specialist input, or Conditional input) and shows how many named UK firms make the shortlist. The four lead disciplines are open by default; tap "Show 7 supporting disciplines" for the full set. Click any cell for the top picks and specialist firms beneath the row. Every cell links directly, e.g. #matrix-cgi-hyperscale.
Lead appointment
Core appointment
Specialist input
Conditional input
Discipline
Cross-dock DC
Fulfilment
Cold-store
Hyperscale DC
Last-mile depot
CGI / visualisationStratumCGI appointment
Architect
Planning consultant
MEP
Structural
Project manager
Cost consultant
BREEAM
Transport
Geotech
Logistics consultant
Full bench detail, every discipline by every typology
Each block lists Tier 1 and Tier 2 UK firms for one discipline within one typology. The matrix above expands these inline on click. The full set is rendered here for direct access and indexing.
Cross-dock DCCGI / visualisation
Track record: StratumCGI delivers verified-view CGI for UK warehouse, distribution centre, fulfilment centre, and data centre schemes across major developers.
Fit 10/10 (Lead appointment). Shortlist: 6 named UK firms.
Top picks
StratumCGI us
Cityscape Digital
Pikcells
AVR London
Specialist firms
Forbes Massie
The Boundary
FulfilmentCGI / visualisation
Track record: StratumCGI delivers verified-view CGI for UK warehouse, distribution centre, fulfilment centre, and data centre schemes across major developers.
Fit 10/10 (Lead appointment). Shortlist: 6 named UK firms.
Top picks
StratumCGI us
Hayes Davidson
Cityscape Digital
Pikcells
Specialist firms
VMI Studio
The Boundary
Cold-storeCGI / visualisation
Track record: StratumCGI delivers verified-view CGI for UK warehouse, distribution centre, fulfilment centre, and data centre schemes across major developers.
Fit 9/10 (Lead appointment). Shortlist: 5 named UK firms.
Top picks
StratumCGI us
Cityscape Digital
Pikcells
Specialist firms
VMI Studio
Darcstudio
Hyperscale DCCGI / visualisation
Track record: StratumCGI delivers verified-view CGI for UK warehouse, distribution centre, fulfilment centre, and data centre schemes across major developers.
Fit 10/10 (Lead appointment). Shortlist: 6 named UK firms.
Top picks
StratumCGI us
Hayes Davidson
Uniform / Somewhere
Cityscape Digital
Specialist firms
Forbes Massie
The Boundary
Last-mile depotCGI / visualisation
Track record: StratumCGI delivers verified-view CGI for UK warehouse, distribution centre, fulfilment centre, and data centre schemes across major developers.
Fit 9/10 (Lead appointment). Shortlist: 6 named UK firms.
Top picks
StratumCGI us
Hayes Davidson
AVR London
Cityscape Digital
Specialist firms
Darcstudio
QuadrantAtelier
Cross-dock DCArchitect
Track record: UMC Architects led DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Chetwoods
Stephen George
AEW
Specialist firms
UMC
Frank Shaw
Michael Sparks
FulfilmentArchitect
Track record: UMC Architects led DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
AEW
TSA Riley
Stephen George
Specialist firms
Frank Shaw
Michael Sparks
SMR
Cold-storeArchitect
Track record: UMC Architects led DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent.
Fit 6/10 (Core appointment). Shortlist: 4 named UK firms.
Top picks
AEW
Specialist firms
Ambrey Baker (D+B)
BRR
BHP Design
Hyperscale DCArchitect
Track record: UMC Architects led DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Scott Brownrigg
Bryden Wood
AEW
Specialist firms
LSI
BHP Design
Dickens
Last-mile depotArchitect
Track record: UMC Architects led DSV Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent.
Fit 6/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
AEW
Stephen George
Specialist firms
SMR
BE Design / LEAD Studio
BRR
Frank Shaw
Cross-dock DCPlanning consultant
Track record: Framptons Town Planning and EDP delivered Symmetry Park Kettering planning alongside Stephen George + Partners.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Lichfields
Savills
Turley
Specialist firms
Framptons
EDP
Pegasus
FulfilmentPlanning consultant
Track record: Framptons Town Planning and EDP delivered Symmetry Park Kettering planning alongside Stephen George + Partners.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Lichfields
Avison Young
Turley
Specialist firms
EDP
Pegasus
Marrons
Cold-storePlanning consultant
Track record: Framptons Town Planning and EDP delivered Symmetry Park Kettering planning alongside Stephen George + Partners.
Fit 6/10 (Core appointment). Shortlist: 4 named UK firms.
Top picks
Lichfields
Turley
Specialist firms
EDP
Pegasus
Hyperscale DCPlanning consultant
Track record: Framptons Town Planning and EDP delivered Symmetry Park Kettering planning alongside Stephen George + Partners.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Lichfields
Avison Young
Savills
Specialist firms
Pegasus
Stantec planning
Turley
Last-mile depotPlanning consultant
Track record: Framptons Town Planning and EDP delivered Symmetry Park Kettering planning alongside Stephen George + Partners.
Fit 7/10 (Core appointment). Shortlist: 6 named UK firms.
Top picks
Avison Young
Carter Jonas
JLL
Specialist firms
Lichfields
Pegasus
Marrons
Cross-dock DCMEP
Track record: Hannan Associates led MEP at Hermes Parcelnet, c.150,000 sq ft cross-dock automated parcel sorting facility, Omega North, Warrington.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Hoare Lea
Cundall
Sweco
Specialist firms
Hannan
Hilson Moran
FulfilmentMEP
Track record: Hannan Associates led MEP at Hermes Parcelnet, c.150,000 sq ft cross-dock automated parcel sorting facility, Omega North, Warrington.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Cundall
Sweco
Ramboll
Specialist firms
Hannan
Hilson Moran
Cold-storeMEP
Track record: Hannan Associates led MEP at Hermes Parcelnet, c.150,000 sq ft cross-dock automated parcel sorting facility, Omega North, Warrington.
Fit 5/10 (Specialist input). Shortlist: 3 named UK firms.
Top picks
Cundall
Ramboll
Specialist firms
Refrigeration specialist + Hannan or Hilson Moran
Hyperscale DCMEP
Track record: Hannan Associates led MEP at Hermes Parcelnet, c.150,000 sq ft cross-dock automated parcel sorting facility, Omega North, Warrington.
Fit 5/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Cundall
Ramboll
Arup
Specialist firms
RED Engineering
Sudlows
TClarke
Last-mile depotMEP
Track record: Hannan Associates led MEP at Hermes Parcelnet, c.150,000 sq ft cross-dock automated parcel sorting facility, Omega North, Warrington.
Fit 3/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Hoare Lea
Cundall
Sweco
Specialist firms
Hannan
Hilson Moran
Cross-dock DCStructural
Track record: RPS Group led civil and structural at DP World London Gateway Logistics Centre and on Amazon UK schemes.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
AECOM
Arup
Specialist firms
RPS
Curtins
BWB
FulfilmentStructural
Track record: RPS Group led civil and structural at DP World London Gateway Logistics Centre and on Amazon UK schemes.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
AECOM
Stantec
Specialist firms
RPS
Curtins
AKT II
Cold-storeStructural
Track record: RPS Group led civil and structural at DP World London Gateway Logistics Centre and on Amazon UK schemes.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
WSP
AECOM
Specialist firms
RPS
Curtins
Hyperscale DCStructural
Track record: RPS Group led civil and structural at DP World London Gateway Logistics Centre and on Amazon UK schemes.
Fit 4/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
Arup
Buro Happold
Specialist firms
RPS
AKT II
HTS Group
Last-mile depotStructural
Track record: RPS Group led civil and structural at DP World London Gateway Logistics Centre and on Amazon UK schemes.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
AECOM
Specialist firms
Curtins
Price and Myers
BWB
Walsh Group
Cross-dock DCProject manager
Track record: Knight Webb ran programme on SEGRO Park Coventry (DHL build-to-suit), Imperial Park Coventry 575,000 sq ft, and MOD Donnington 1m sq ft.
Fit 4/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Gleeds
Mace
Turner and Townsend
Specialist firms
Knight Webb
Trinity Property
Core Five
FulfilmentProject manager
Track record: Knight Webb ran programme on SEGRO Park Coventry (DHL build-to-suit), Imperial Park Coventry 575,000 sq ft, and MOD Donnington 1m sq ft.
Fit 4/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Gleeds
Mace
Linesight
Specialist firms
Knight Webb
Core Five
Calford Seaden
Cold-storeProject manager
Track record: Knight Webb ran programme on SEGRO Park Coventry (DHL build-to-suit), Imperial Park Coventry 575,000 sq ft, and MOD Donnington 1m sq ft.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
Gleeds
Mace
Specialist firms
Knight Webb
Core Five
Hyperscale DCProject manager
Track record: Knight Webb ran programme on SEGRO Park Coventry (DHL build-to-suit), Imperial Park Coventry 575,000 sq ft, and MOD Donnington 1m sq ft.
Fit 5/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Mace
Turner and Townsend
Linesight
Currie and Brown
Specialist firms
Faithful and Gould
Core Five
Last-mile depotProject manager
Track record: Knight Webb ran programme on SEGRO Park Coventry (DHL build-to-suit), Imperial Park Coventry 575,000 sq ft, and MOD Donnington 1m sq ft.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
Gleeds
Turner and Townsend
Specialist firms
Knight Webb
Core Five
Cross-dock DCCost consultant
Track record: Gardiner and Theobald publishes the canonical UK warehousing market intelligence and runs cost on UK distribution-centre programmes.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Gardiner and Theobald
Gleeds
Currie and Brown
Specialist firms
Knight Webb
Core Five
Exigere
FulfilmentCost consultant
Track record: Gardiner and Theobald publishes the canonical UK warehousing market intelligence and runs cost on UK distribution-centre programmes.
Fit 3/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Gardiner and Theobald
Currie and Brown
Turner and Townsend
Specialist firms
Knight Webb
Core Five
Cold-storeCost consultant
Track record: Gardiner and Theobald publishes the canonical UK warehousing market intelligence and runs cost on UK distribution-centre programmes.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
Gardiner and Theobald
Currie and Brown
Specialist firms
Knight Webb
Stace
Hyperscale DCCost consultant
Track record: Gardiner and Theobald publishes the canonical UK warehousing market intelligence and runs cost on UK distribution-centre programmes.
Fit 4/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
Linesight
AECOM
Currie and Brown
Turner and Townsend
Specialist firms
Arcadis
Exigere
Last-mile depotCost consultant
Track record: Gardiner and Theobald publishes the canonical UK warehousing market intelligence and runs cost on UK distribution-centre programmes.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
Gardiner and Theobald
Gleeds
Specialist firms
Knight Webb
Core Five
Cross-dock DCBREEAM
Track record: UMC's DSV Mercia Park scheme certified BREEAM Excellent, with Cundall and Hoare Lea on the UK industrial sustainability bench.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Hoare Lea
Cundall
Sweco
Specialist firms
BRE
Hodkinson
FulfilmentBREEAM
Track record: UMC's DSV Mercia Park scheme certified BREEAM Excellent, with Cundall and Hoare Lea on the UK industrial sustainability bench.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Hoare Lea
Cundall
AECOM
Specialist firms
Hodkinson
Greengage
Cold-storeBREEAM
Track record: UMC's DSV Mercia Park scheme certified BREEAM Excellent, with Cundall and Hoare Lea on the UK industrial sustainability bench.
Fit 4/10 (Specialist input). Shortlist: 3 named UK firms.
Top picks
Cundall
Ramboll
Specialist firms
Hodkinson
Hyperscale DCBREEAM
Track record: UMC's DSV Mercia Park scheme certified BREEAM Excellent, with Cundall and Hoare Lea on the UK industrial sustainability bench.
Fit 5/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Cundall
Buro Happold
Ramboll
Specialist firms
AESG
Greengage
Last-mile depotBREEAM
Track record: UMC's DSV Mercia Park scheme certified BREEAM Excellent, with Cundall and Hoare Lea on the UK industrial sustainability bench.
Fit 3/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
Hoare Lea
Cundall
Specialist firms
Hodkinson
Greengage
Cross-dock DCTransport
Track record: WSP and Stantec run transport planning on UK distribution park applications across the Midlands logistics belt.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
Stantec
AECOM
Specialist firms
Curtins
BWB
i-Transport
FulfilmentTransport
Track record: WSP and Stantec run transport planning on UK distribution park applications across the Midlands logistics belt.
Fit 3/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
WSP
Stantec
Specialist firms
BWB
Markides
i-Transport
Cold-storeTransport
Track record: WSP and Stantec run transport planning on UK distribution park applications across the Midlands logistics belt.
Fit 2/10 (Conditional input). Shortlist: 3 named UK firms.
Top picks
WSP
Specialist firms
BWB
i-Transport
Hyperscale DCTransport
Track record: WSP and Stantec run transport planning on UK distribution park applications across the Midlands logistics belt.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
Royal HaskoningDHV
WSP
Arup
Specialist firms
BWB
Markides
Last-mile depotTransport
Track record: WSP and Stantec run transport planning on UK distribution park applications across the Midlands logistics belt.
Fit 3/10 (Specialist input). Shortlist: 6 named UK firms.
Top picks
WSP
Arup
Specialist firms
Vectos
Stilwell
Markides
i-Transport
Cross-dock DCGeotech
Track record: RSK delivers ground investigation on UK distribution centre sites for major developer portfolios.
Fit 1/10 (Conditional input). Shortlist: 6 named UK firms.
Top picks
RSK
WSP
AECOM
Specialist firms
Soil Engineering
Fairhurst
Listers
FulfilmentGeotech
Track record: RSK delivers ground investigation on UK distribution centre sites for major developer portfolios.
Fit 1/10 (Conditional input). Shortlist: 5 named UK firms.
Top picks
RSK
AECOM
Specialist firms
Fairhurst
Listers
Geotechnics Ltd
Cold-storeGeotech
Track record: RSK delivers ground investigation on UK distribution centre sites for major developer portfolios.
Fit 1/10 (Conditional input). Shortlist: 3 named UK firms.
Top picks
RSK
Specialist firms
Fairhurst
Geotechnics Ltd
Hyperscale DCGeotech
Track record: RSK delivers ground investigation on UK distribution centre sites for major developer portfolios.
Fit 2/10 (Conditional input). Shortlist: 5 named UK firms.
Top picks
RSK
Fugro
AECOM
Specialist firms
Listers
Ground Engineering Services
Last-mile depotGeotech
Track record: RSK delivers ground investigation on UK distribution centre sites for major developer portfolios.
Fit 1/10 (Conditional input). Shortlist: 4 named UK firms.
Top picks
RSK
WSP
Specialist firms
Soil Engineering
Fairhurst
Cross-dock DCLogistics consultant
Track record: SCCG and LPC International advise UK occupiers on warehouse and distribution facility operational design.
Fit 4/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
LPC International
SCCG
Specialist firms
Hatmill
Davies and Robson
Total Logistics
FulfilmentLogistics consultant
Track record: SCCG and LPC International advise UK occupiers on warehouse and distribution facility operational design.
Fit 5/10 (Specialist input). Shortlist: 5 named UK firms.
Top picks
SCCG
LPC International
Specialist firms
Hatmill
BoxLogic
Bisham
Cold-storeLogistics consultant
Track record: SCCG and LPC International advise UK occupiers on warehouse and distribution facility operational design.
Fit 4/10 (Specialist input). Shortlist: 3 named UK firms.
Top picks
LPC International
Specialist firms
Hatmill (cold-chain)
Bisham
Hyperscale DCLogistics consultant
Track record: SCCG and LPC International advise UK occupiers on warehouse and distribution facility operational design.
Fit 2/10 (Conditional input). Shortlist: 3 named UK firms.
Top picks
Operator-led
Specialist firms
Total Logistics
SCCG
Last-mile depotLogistics consultant
Track record: SCCG and LPC International advise UK occupiers on warehouse and distribution facility operational design.
Fit 4/10 (Specialist input). Shortlist: 4 named UK firms.
Top picks
SCCG
Specialist firms
Paul Trudgian
BoxLogic
Hatmill
UK design team shortlist summaries, one per typology
Five 80-word reads. Pick a typology in the form above and we will scroll you to the matching summary and open the strongest cell in the matrix.
Cross-dock distribution centre
Which UK design firms shortlist for cross-dock distribution centre design?
For a cross-dock build, your architect and your MEP do the heavy lifting, because the dock count and the slab decide whether your operator's throughput model works. Your architect pick: UMC Architects on the back of DSV Mercia Park (522,000 sq ft, BREEAM Excellent), with Chetwoods or Stephen George + Partners as alternatives that work the SEGRO and Verdion estates. For your MEP, take Hannan Associates over Hoare Lea here. Hannan led Hermes Parcelnet at Omega North, a c.150,000 sq ft automated parcel sort. Get your planning consultant in early: Framptons or EDP signs the access junction before your architect's Stage 2.
Fulfilment centre
Which UK design firms shortlist for fulfilment centre design?
For a fulfilment centre, your architect and your project manager run the show. The automation rack layout decides your column grid and your dock count, and the build schedule is dictated by your operator's peak-season cutover. Your architect pick: AEW or TSA Riley over Stephen George + Partners. Both have the Amazon and DHL panellised design-and-build credits you need. For your MEP, go with Cundall over Hoare Lea, because their Ramboll team co-runs your conveyor power and HVAC peaks. Bring in a logistics consultant, SCCG or LPC International, to scope throughput before your architect locks the dock count.
Cold-store and temperature-controlled warehouse
Which UK design firms shortlist for cold-store warehouse design?
Cold-store is different from your other sheds. Most UK schemes are run by a design-and-build contractor with a refrigeration consultant attached, not an architect. Your only top-pick architect is AEW, with Ambrey Baker, BRR, or BHP Design as the design-and-build alternatives. For your MEP, Cundall or Ramboll both work. They run BREEAM and refrigeration in parallel, which is what you need. The appointment you will forget is the refrigeration specialist. Brief them before your structural engineer signs off the slab loading. Skip that and your chamber temperatures will not certify against your operator's cold-chain spec.
Hyperscale data centre
Which UK design firms shortlist for hyperscale data centre design?
Hyperscale puts your MEP and your structural engineer at the centre of the brief. The M+E load is the building. Your MEP pick: Cundall, Ramboll, or Arup, with RED Engineering and Sudlows as the data-centre specialists who carry the rack-power and cooling depth you need. For your architect, go with Scott Brownrigg or Bryden Wood over Stephen George + Partners. Both have UK hyperscale credits where the architect handles the shell, not the interior. Bring in transport early: Royal HaskoningDHV on grid-connection junction capacity. That single conversation kills more hyperscale schemes than the planning system.
Last-mile delivery depot
Which UK design firms shortlist for last-mile depot design?
Last-mile depots front-load your planning and your transport. Urban-edge sites trade your dock count against junction capacity and HGV swept-path acceptance, so your planning brief starts earlier than on a big shed. For your planning, go with Avison Young, Carter Jonas, or JLL over Lichfields. The urban-edge brief sits closer to their commercial work than to Lichfields' big-shed practice. Your architect pick: AEW or Stephen George + Partners, with BE Design, LEAD Studio, or BRR as boutique alternatives. The appointment you will skip and regret is BREEAM. Without BREEAM Excellent you lose the local-authority planning condition and six months on the programme.
Cold-store is design-and-build-contractor-led, so fewer UK firms publish portfolio credits at the named-discipline level. The cold-store column lists firms with at least one verified UK temperature-controlled credit, but the bench is genuinely thinner than for cross-dock or fulfilment.
Cross-dock and fulfilment share the same Tier 1 supporting bench. WSP, AECOM, Cundall, Hoare Lea, Gardiner and Theobald, and Gleeds appear on both columns of the matrix. The Tier 2 architect overlap is narrower: Frank Shaw Associates, Michael Sparks, and SMR cover both typologies.
Hyperscale data centre breaks the cross-dock pattern in three rows. Scott Brownrigg and Bryden Wood replace the cross-dock architects. RED Engineering leads MEP, with Sudlows on the Tier 2 bench. Linesight and Currie and Brown run programme on data-centre work where Knight Webb and Trinity run programme on cross-dock.
Last-mile depot breaks the pattern in different rows. BE Design, LEAD Studio, and BRR replace the cross-dock architects. Avison Young, Carter Jonas, and JLL run planning on last-mile schemes. Vectos and Stilwell deliver the transport work.
Cold-store stands apart from the other four typologies. UK cold-store schemes are usually delivered by refrigeration-led design-and-build contractors with refrigeration consultants attached, not by the architect-led teams that run cross-dock and fulfilment.
StratumCGI sits in the Tier 1 column on the CGI row across all five typologies, with hyperscale data centre as the priority commission. The wider UK arch-viz Tier 1 bench for hyperscale includes Hayes Davidson, Uniform / Somewhere, and Cityscape Digital, with Forbes Massie and The Boundary on the Tier 2 specialist bench.
Eleven disciplines, one programme
Disciplines to Commission for a UK Cross-Dock Distribution Centre
Delivering a UK cross-dock distribution centre needs eleven separate appointments: architect, MEP consultant, structural engineer, planning consultant, project manager and employer's agent, cost consultant, CGI and architectural visualisation partner, BREEAM assessor, transport and highways consultant, geotechnical engineer, and logistics or supply chain consultant. Each is a distinct commission with its own scope, its own fee, and its own verified shortlist. Skipping one, or rolling two into a single appointment that does not have the authority to deliver both, is the most common procurement mistake on UK industrial work.
The eleven-discipline artefact pack a UK cross-dock developer commissions: planning verified views, dock leveller details, MEP plant placement, and pre-let agent particulars.
Logistics consultantStage 0 to Stage 2
Project managerStage 0 to Stage 5
Planning consultantStage 1 to Stage 4
Transport and highwaysStage 1 to Stage 4
Geotechnical engineerStage 1 to Stage 2
ArchitectStage 2 to Stage 5
Structural engineerStage 2 to Stage 5
MEP consultantStage 2 to Stage 5
BREEAM assessorStage 2 to Stage 5
Cost consultantStage 2 to Stage 5
CGI and visualisationStage 2 to Stage 4
Commissioning sequence for a UK cross-dock distribution centre across RIBA Plan of Work 2020 stages. The logistics consultant and project manager engage at Stage 0; planning, transport, and geotechnical at Stage 1; architect, structural, MEP, BREEAM, cost, and CGI at Stage 2.
Architect
The architect is the lead designer for the building shell, yard layout, dock arrangement, mezzanine, office pod, and external envelope. UMC Architects (DSV Logistics, Mercia Park, 522,000 sq ft including a 112,000 sq ft cross-dock terminal, BREEAM Excellent), Chetwoods (Altitude at Magna Park, 574,258 sq ft with 21 m haunch for GLP), Stephen George + Partners (Symmetry Park Kettering, 500,000 sq ft cross-dock), Frank Shaw Associates (Amazon Fulfilment Centre Doncaster IPort for Verdion), and AEW Architects sit at the head of the UK cross-dock bench.
MEP consultant (mechanical, electrical, plumbing)
The MEP consultant sets dock leveller power, yard lighting, sprinkler density, sortation power feeds, and the cooling architecture for any chilled or controlled-temperature element of the building. Hannan Associates ran MEP on Hermes Parcelnet's c.150,000 sq ft cross-dock automated parcel sorting facility at plot 1A, Omega North, Warrington. Hoare Lea, Cundall, Ramboll, and Sweco sit alongside on UK cross-dock and adjacent fulfilment work.
Structural engineer
The structural engineer designs the portal frame, the slab specification (FM1 for cross-dock floors with minimal racking, FM2 or FM3 where high-bay racking is introduced), foundations, lateral stability, and any mezzanine framing. RPS Group is named civil and structural for Amazon at DP World London Gateway. WSP, Curtins, and Price and Myers carry comparable UK industrial portfolios, with steel detailing typically delivered through the contractor's specialist (Caunton Engineering, Severfield).
Planning consultant
The planning consultant leads local plan allocation strategy, pre-application engagement, Environmental Impact Assessment screening, full planning application preparation, and Section 106 negotiation, acting as the developer's representative at planning committee and at any subsequent appeal. The Symmetry Park Kettering team named Framptons Town Planning and EDP. Lichfields, Avison Young, Carter Jonas, and Pegasus Group are the recurring names across UK logistics parks. For schemes above the Section 35 MW threshold, the consenting route shifts from a Town and Country Planning Act application to the NSIP regime; January 2026 NSIP opt-in regulations target a 12-month consent window. See the dedicated playbook on data centre marketing for the full NSIP process.
Project manager and employer's agent
The project manager and employer's agent runs procurement, programme, and contract administration on behalf of the developer or end-user owner. Knight Webb credits include SEGRO Park Coventry (DHL build-to-suit), SEGRO Park Hayes, XPO Logistics at SEGRO East Midlands Gateway, the John Lewis Urban Delivery Hub at South Central Southampton, Imperial Park Coventry (575,000 sq ft), Waitrose Coulsdon, ASOS Barnsley, and 1 million sq ft for the MOD at Donnington. Trinity Property Consultants ran PM at Symmetry Park Kettering.
Gleeds, Mace, and Currie and Brown sit on the wider bench.
The architect or project manager carries the Principal Designer duty under CDM 2015 Regulations; on a typical SEGRO scheme this role sits with the project manager, with UMC Architects, AEW, or Knight Webb named as Principal Designer on schemes where the project manager and architect appointment is held by the same practice.
Cost consultant (quantity surveyor)
The cost consultant produces the cost plan and elemental estimate at each RIBA stage gate, manages NEC4 or JCT Design and Build tender preparation, administers interim valuations under the building contract, and certifies the final account at practical completion. Knight Webb cross-lists into this appointment on most of its instructions. Gleeds, Currie and Brown, AECOM cost consulting, and Gardiner and Theobald sit alongside, with Gardiner and Theobald publishing the canonical UK warehousing market intelligence that most other consultants reference for benchmark rates.
CGI and architectural visualisation partner
The CGI partner produces photoreal still and animation outputs for planning, marketing, pre-let agent particulars, and end-user investor packs. StratumCGI runs the named UK warehouse and logistics CGI service, with sibling pages for distribution centre CGI, fulfilment centre CGI, data centre CGI, and industrial CGI. Verified views, yard discipline, and dock leveller height matched to the 1,200 mm UK trailer bed are the production rules; the camera position references a planning drawing or a surveyor coordinate, not an art-directed angle.
BREEAM assessor and sustainability consultant
BRE, Hoare Lea sustainability, and Cundall lead UK industrial BREEAM assessment on cross-dock and logistics DC schemes; AESG, Ramboll sustainability, and Buro Happold sustainability sit alongside on the wider bench. The BREEAM assessor runs the certification target and sustainability strategy, is mandatory for UK industrial planning approvals targeting BREEAM Very Good or Excellent, is appointed at RIBA Stage 1 (preparation and brief), scopes the credits at Stage 2, runs the assessment alongside design at Stage 3 to 4, and certifies at practical completion. UMC's DSV Mercia Park is certified BREEAM Excellent. Hoare Lea Fire, OFR Consultants, and Tenos lead UK industrial fire engineering; their scope covers the Approved Document B strategy, sprinkler density specification, and means-of-escape travel distances, all of which are fixed by slab and column geometry alongside the structural engineer's framing decision.
Transport consultant and highways
WSP, Royal HaskoningDHV, and Curtins lead UK industrial transport on cross-dock and fulfilment schemes; their scope covers Transport Assessment, Section 278 highway agreement, Section 38 adoption, yard circulation modelling against HGV swept-path constraints, and access junction strategy with the highway authority. BWB Consulting, Vectos, and Stilwell Partnership sit on the specialist bench for logistics-park access work where junction capacity and swept-path acceptance are the critical approval variables.
Geotechnical and ground engineering
RSK Group, Soil Engineering Ltd, and Fairhurst lead UK geotechnical appointments on cross-dock and logistics-park schemes; their scope covers the Phase 1 desk study and Phase 2 intrusive investigation to BS 5930, contamination liability assessment under Part 2A of the Environmental Protection Act, slab bearing capacity certification against dock-leveller point loads and yard plant wheel loads, and piling specification where ground conditions preclude a ground-bearing slab. Geotechnical Engineering Ltd and Listers Geotechnical sit alongside on the specialist bench. Cross-dock slabs demand a piled solution where ground-bearing pressures from heavy yard plant exceed the natural slab capacity.
Logistics and supply chain consultant (operational layer)
LPC International, Hatmill, and BoxLogic lead UK logistics and supply chain consultancy on cross-dock and fulfilment schemes; their scope covers the Operational Brief and Warehouse Concept Design before the building shell is locked: dock count defined by throughput mode (unit-load or pallet-flow), marshalling area dimensioned against trailer spot pitch, racking pitch calibrated to the ASRS or conventional racking specification, and automation strategy expressed as a WMS and WCS requirement ready for vendor tender. Davies and Robson, Bisham Consulting, SCP UK, SCCG, Paul Trudgian, and Total Logistics sit on the specialist bench. The point of engaging this discipline early is that the dock count and marshalling area drive the floor plate, and the floor plate drives the architect's brief.
Cross-dock by-discipline detail
UK Cross-Dock Distribution Centre Design Team, by Discipline
The defining feature of a UK cross-dock design programme is that the planning consultant and transport consultant are appointed before the architect reaches Stage 2 concept, because the access junction and the highway capacity decide the dock count. Named-project rosters at Symmetry Park Kettering and DSV Mercia Park confirm the same pairing pattern recur: Framptons and EDP on planning alongside Stephen George + Partners and UMC, Knight Webb running employer's agent and cost on most SEGRO, Verdion, and DSV instructions. Coordination across the eleven disciplines runs through a BIM model from RIBA Stage 2 onwards; the architect's BIM lead aligns the MEP consultant's services model and the structural engineer's frame model in a federated coordination model the project manager reviews weekly.
Wireframe overlay on a UK distribution centre render, used to coordinate architect, MEP, structural, and CGI deliverables at RIBA Stage 2.
The standard RIBA Plan of Work 2020 procurement sequence for a UK cross-dock distribution centre follows the sequencing the highway and ground constraints impose:
Site acquisition: logistics consultant scopes operational throughput and dock count.
Pre-application: planning and transport consultants track on the highway and allocation strategy from Stage 1.
Stage 2 concept: architect and structural engineer develop the building shell and yard.
Stage 2 MEP joining: MEP consultant locks slab services and yard infrastructure before the floor plate is issued for structural design.
Stage 2 certification: BREEAM assessor sets the certification target.
Stage 0 onwards: project manager runs programme from the start.
Stage 1 ground investigation: geotechnical engineer delivers site investigation.
Stage 2 CGI: visualisation partner produces the verified-view pack for the pre-application meeting and application.
Reference projects to study at named-team level include Symmetry Park Kettering (Stephen George + Partners, Framptons Town Planning, EDP, WSP, Hannan, Trinity Property Consultants), DSV Mercia Park (UMC Architects, BREEAM Excellent), Altitude at Magna Park (Chetwoods for GLP), and Hermes Parcelnet at Omega North (Hannan MEP). For a closer look at how the cross-dock typology renders in pre-let and planning images, see central belt distribution centre, Magna Park extension, West Midlands distribution warehouse, and North West logistics hub.
Fulfilment centre team
UK Fulfilment Centre Design Team, and Where It Diverges from Cross-Dock
A UK fulfilment centre design team replaces the cross-dock architect bench with Frank Shaw Associates (Amazon Fulfilment Centre, Doncaster IPort, more than one million sq ft for Verdion), Michael Sparks Associates (Amazon Tilbury), SMR Architects (Waitrose Enfield CFC), TSA Riley (Dunstable), and AEW Architects on PLP's North of England framework. The bench diverges from cross-dock mainly at three appointments: the architect, the MEP consultant, and the logistics consultant, because the floor plate is bigger, the racking pitch tighter, and the automation footprint larger.
Fulfilment centre interior, where automation rack pitch and conveyor power feeds drive the column grid the architect locks at concept.
The MEP consultant on a fulfilment centre carries a heavier brief than on a cross-dock because the building runs sortation automation, goods-to-person systems, and integrated conveyor loops powered from a single MV intake. The power draw on a large fulfilment centre regularly exceeds 3 MVA.
The MEP consultant sizes the MV intake, the transformer arrangement, the standby generation, and the fire suppression strategy. Hannan Associates and Cundall recur in this appointment. The logistics consultant on a fulfilment scheme engages earlier than on a cross-dock build, because the racking pitch, the picking strategy, and the automation choice fix the floor plate before the architect is fully briefed. Hatmill, BoxLogic, and SCCG are the recurring UK logistics consultant appointments.
UK Hyperscale Data Centre Architect and Engineering Bench
Scott Brownrigg leads the UK hyperscale data centre architect bench, with Belvedere Data Centre (344,445 sq ft Tier III for Stratus Data Centres) and West London Premier Park (22,365 sqm at 72MW for Pure Data Centres on a SEGRO site, approved May 2026). Bryden Wood, LSI, BHP Design, Dickens, and 3DReid sit on the same bench. Named-project overlap with the logistics-architect bench sits close to zero, which is why a hyperscale brief and a cross-dock brief almost never share a single architect at named-project level. Belvedere itself comprises two 18MW Tier III blocks on a Thames-side brownfield powered directly by the adjacent Riverside waste-to-energy plant; the dual-portfolio breadth is the cleanest "DC specialist that scales across schemes" evidence point in the UK SERP.
Hyperscale data centre, where the M and E load is the building and the architect handles shell and entrance pod rather than internal layout.
Beyond Scott Brownrigg, the architect bench reads as Bryden Wood (data centre programme of more than 25 years across Dublin, London, Madrid, and Milan, with the studio publishing its own platforms-of-design and DfMA capex-reduction case-study material), LSI Architects, BHP Design (DC-only firm established 2007), Dickens Architects, and 3DReid. Mission-critical engineering and commissioning sits with Arup, Sweco (20+ campuses, EUR 20bn portfolio), WSP (mission-critical EMEA lead), Stantec, RED Engineering (1,050+ commissions, 40 GW masterplanned since 2017), Buro Happold, Sudlows (Uptime Institute Tier Designers), 2bm, and Datalec.
The point of engaging a DC-specialist architect over a logistics-led studio is that the building is a process plant with a roof on it, not an envelope around racking. The cooling architecture, the power feed strategy, the security envelope, and the commissioning regime are the brief, not the floor plate and the dock face. For a closer look at how the typology renders in planning and investor packs, see data centre CGI, hyperscale AI data centre campus, and Manchester hyperscale data centre.
Last-mile depot team
UK Last-Mile Depot Architect and Planning Team
UK last-mile depot work is led by SMR Architects, with 350 plus feasibilities in 2022 and a near one million sq ft pipeline. BE Design Group ran Leyton Logistics Hub. BRR Architecture covers the urban-edge thought-piece position. The planning bench shifts to Avison Young, Carter Jonas, and Vectos for highways. The bench differs from a cross-dock team because the site is urban or urban-edge, the floor plate is smaller, the building is often multi-storey, and the planning constraints are residential amenity rather than highway capacity.
Urban-edge last-mile depot with multi-storey logistic and office stacking, the typology constraint that splits the planning and transport bench from a cross-dock team.
Reference schemes for this typology include 25 Mandela Way in Southwark, a four-storey multi-tenant logistic and office building that defines the urban-edge typology in Central London. The planning consultant on a last-mile scheme works to a different brief from a cross-dock consultant: residential amenity, daylight and sunlight studies, servicing strategy at street level, and night-time delivery hours dominate. Avison Young and Carter Jonas recur. The transport consultant on this bench (Vectos, Stilwell Partnership) carries a different toolkit, focused on van loading bays and cycle-logistics integration rather than HGV swept paths and S278 access junctions.
For a closer look at how the last-mile typology renders in planning and pre-let images, see urban-edge last-mile depot.
Firms that work on both DCs and data centres
Firms That Work on Both UK Distribution Centres and Data Centres
Six UK firms credibly carry one team across both a logistics shed and a hyperscale data centre: McLaren Group on the contractor side, and RPS, WSP, Buro Happold, Stantec, and Arup on the consultant side. The qualifier on the six is that the crossover usually sits in the engineering or consulting practice, not at named-architect level, because the architectural bench for hyperscale is a separate specialism.
Cross-dock distribution centre, the typology that defines the crossover bench: same architect can scale to fulfilment, the same MEP scales to data centre.
Pure-play logistics architects (Chetwoods, UMC) and pure-play data centre architects (Scott Brownrigg) almost never cross at named-project level. UMC Architects declares both logistics and data centre as sectors but holds named projects on the logistics side only; the crossover argument rests on UMC's own sector page rather than a published DC project credit.
For a developer evaluating whether to commission one multidisciplinary team or two specialist teams, the question is whether the saving in coordination overhead outweighs the loss of typology depth at architect level. On a single-typology scheme the answer is usually two specialist teams, with the cross-disciplinary practice taking one role. On a mixed campus (a logistics park with a co-located data centre), a multidisciplinary lead with two specialist architects underneath is the recurring pattern.
Architectural CGI in the commissioning order
Architectural CGI in the UK Distribution Centre Commissioning Order
Architectural CGI sits between the architect's RIBA Stage 2 concept and the planning consultant's pre-application meeting, then again before the agent's pre-let marketing campaign. Verified-view CGI references the surveyor coordinate, the dock leveller height, and the trailer swing radius the architect has already drawn, not an art-directed angle. Engaging the CGI partner at Stage 2 (rather than at Stage 4 marketing) means the camera positions are chosen against the planning drawing rather than the marketing brochure, and the dock leveller, trailer pitch, and yard swept-path read at scale on every image.
What to ask for at Stage 2 versus Stage 3 is a procurement question, not a creative one. Stage 2 deliverables: pre-application image pack with three to six camera positions on agreed LVIA viewpoints, dock face elevation showing the 1,200 mm leveller height and trailer bed mismatch, rooftop plant deck and yard chiller compound shown in the position the MEP consultant has actually drawn.
Stage 3 deliverables: leasing hero, occupier-branded yard scene with named livery on actual fleet, and investor-pack crops at exchange. Engaging the CGI partner at RIBA Stage 2 means a single photorealistic 3D model, coordinated against the architect's Stage 2 drawings and the MEP consultant's yard services layout, carries verified-view planning stills, pre-let agent particulars, and investor-pack crops through to exchange without a second commission.
Cushman and Wakefield's Q1 2026 data records 8.4m sq ft of UK industrial and logistics space leased across 53 transactions, against a speculative development pipeline at its lowest since 2017. That supply pressure moves the pre-let programme upstream. I brief developer teams on that sequence regularly: when agent particulars come forward earlier, the CGI commission follows. Dock leveller geometry, yard discipline, and trailer pitch need to be in the verified-view model before the planning submission, not drawn for the brochure at Stage 4.
George NicolaDirector, UK at StratumCGI
Recurring procurement mistakes
Common Procurement Mistakes on UK Cross-Dock Distribution Centre Projects
The recurring procurement mistakes on UK cross-dock distribution centre projects: appointing one architect to deliver both a logistics shed and a data centre, leaving MEP out of the concept stage, ordering CGI after planning submission rather than before pre-application, and treating the planning consultant as a documentation role rather than a strategy role. Each costs programme time, fee budget, or both, and each is avoidable at first interview.
Before and after photomontage from a UK industrial scheme, the verified-view CGI deliverable that planning officers and end-user investors both reference.
Mistake one: a single architect for a mixed logistics-and-DC campus. The named-project bench for DC architecture (Scott Brownrigg, Bryden Wood, LSI, BHP Design, Dickens, 3DReid) does not overlap with the named-project bench for cross-dock (UMC, Chetwoods, Stephen George, Frank Shaw, AEW). Asking a logistics-led architect to design a hyperscale block, or a DC-specialist studio to draw a 500,000 sq ft cross-dock, is a procurement mismatch even when the firm declares both sectors.
Mistake two: no MEP at concept. Dock leveller power, sortation feeds, and the yard chiller compound footprint are concept-stage decisions, not Stage 4 detail. Locking the floor plate without an MEP at the table forces a coordination round at Stage 3 that costs both fee and programme. Hannan, Hoare Lea, and Cundall sit on the cross-dock bench because they are willing to engage at concept.
Mistake three: late CGI. Engaging the visualisation partner at Stage 4 marketing means the camera position is a marketing brief, not a planning brief. The dock leveller height, the trailer pitch, and the yard swept-path study are not in the model, the verified-view standard cannot be met, and a second commission is needed for the planning pack. Engaging the CGI partner at Stage 2 covers planning, leasing, and investor work from one base 3D model.
Commissioning FAQs
UK Cross-Dock Commissioning Questions
Who designs cross-dock distribution centres in the UK?
+
UK cross-dock distribution centres are typically designed by a small bench of logistics-specialist architects, including UMC Architects (DSV Mercia Park), Chetwoods (Altitude at Magna Park for GLP), Stephen George + Partners (Symmetry Park Kettering), Frank Shaw Associates (Amazon Doncaster IPort for Verdion), and AEW Architects. Each typically partners with an MEP consultant such as Hannan Associates, a structural engineer such as RPS or WSP, and a project manager and cost consultant such as Knight Webb, Gleeds, or Currie and Brown.
Is Knight Webb an architect?
+
No. Knight Webb operates as employer's agent, project manager, and cost consultant on UK industrial and logistics work, not as an architect. Verified credits include SEGRO Park Coventry (DHL build-to-suit), SEGRO Park Hayes, XPO Logistics at SEGRO East Midlands Gateway, the John Lewis Urban Delivery Hub at South Central Southampton, Imperial Park Coventry at 575,000 sq ft, Waitrose Coulsdon, ASOS Barnsley, and the MOD scheme at Donnington at 1 million sq ft.
Who designs hyperscale data centres in the UK?
+
The UK hyperscale data centre architect bench is led by Scott Brownrigg (Belvedere Data Centre at 344,445 sq ft for Stratus Data Centres, and West London Premier Park at 22,365 sqm and 72MW for Pure Data Centres on a SEGRO site, approved May 2026), Bryden Wood, LSI Architects, BHP Design, Dickens Architects, and 3DReid. Mission-critical engineering is led by Arup, Sweco, WSP, Stantec, RED Engineering, Buro Happold, and Sudlows.
Does the same architect design both distribution centres and data centres in the UK?
+
Rarely at named-project level. The logistics-architect bench and the hyperscale data centre bench overlap by less than one firm at named-project level. Six multidisciplinary firms can credibly carry one team across both typologies through their wider engineering and consulting practice: McLaren Group, RPS, WSP, Buro Happold, Stantec, and Arup. UMC Architects declares both logistics and data centre as sectors but holds named projects only on the logistics side.
Related reading and services
Verified-View CGI Across the Logistics Typologies
The discipline map above sits alongside the StratumCGI service pages, where the production workflow that supports planning, pre-let, and investor packs is set out by typology.
Warehouse and logistics CGI
Verified-view CGI for cross-dock, fulfilment, and last-mile schemes, briefed at RIBA Stage 2 onwards.
Data centre CGI
Hyperscale data centre visualisation, including campus aerials, mission-critical interiors, and investor-pack crops.
UK warehouse typologies guide
The six conventional UK warehouse building types, occupier mapping, and planning-evidence framing.
Five-stage production process
How planning stills, leasing heroes, and investor-pack crops are produced from one base 3D model.
